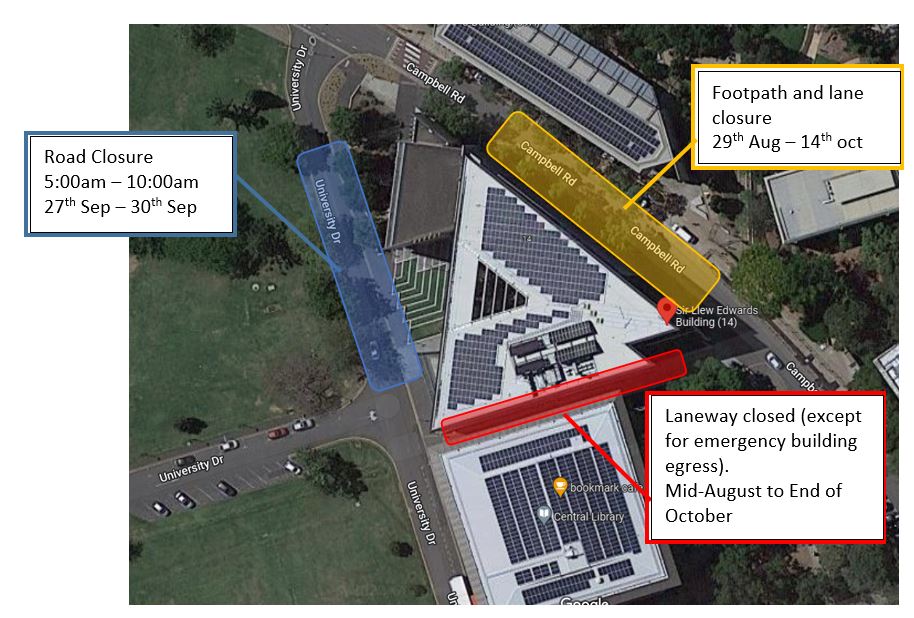

There will be disruption to the Sir Llew Edwards Building (14) and surrounding areas due the facade replacement project. Works over the coming weeks will include continued demolition of the facade at the eaves from a boom on Campbell Road. This will result in noisy works and require exclusion zones and ultimately footpath closures surrounding the boom. Removal of the scaffold within the Atrium will begin on the 27th September (pending wet weather) and will require some road and footpath closures.
Further disruptions will continue to be communicated.
Expected completion date for the project is January 2023. Below is some further detail on likely disruptions over the coming few weeks.
When
- Start: Thursday, 22nd September 2022
- Finish: Friday, 14th October 2022
- Times: Generally, site hours will be within 6:00am – 5:00pm
Affected Areas
Affected Area & Disruption | Time | Date |
---|---|---|
Campbell Road Elevation Installation of facade to fins and eaves
| 6:00am – 5:00pm | 29th August 2022 – 14th October 2022 |
Duhig Lane Scaffold build and demolition of panels on Duhig North Building
| 6:00am – 5:00pm | Mid-August to End of October |
Atrium Installation of cladding
Scaffold Removal
| 6:00am – 5:00pm |
8th August 2022 – 26th September2022
27th September 2022 – 6th October 2022 [Pending Weather] |
University Drive Road Closure for scaffold dismantle
| 6:00am – 10:00am | 27th September – 30th September [Pending Weather] |
Project details
Sir Llew Edwards Building facade replacement project.
Contact
Casey Fredrickson, Project Manager (Infrastructure):
- Call: 0408 339 936
- Email: c.fredrickson@uq.edu.au
We apologise for the inconvenience this may cause and thank you for your understanding during this time.
